The primary objective of the drilling programme is to provide 25 m spaced drill sampling within the two , high-grade Starter Pits (up to 35 m deep) within the main La India Open Pit Mineral Reserve. As already announced, drilling on the Northern Starter Pit has been completed with 25 drill holes for 1,273 m, four of which have twinned existing RC drill holes. Drilling is nearing completion on the Southern Starter Pit with 15 holes for 897 m completed, also including four RC-twin holes (Figure 1). Drill results have now been received for a total of six drill holes which are all located at the northern end of the Northern Starter Pit, two of which (LIDC404 and LIDC405) have been previously reported. The drilling results received to date support, and add considerable confidence to, the geological model used in the mineral resource and reserve estimation and mine plan, and include two significant intercepts.
Highlights
- LIDC406 intersected 17.90 m (17.4 m true width) at 3.27 g/t gold from 24.55 m drill depth, including 2.1 m @ 15.1 g/t gold from 36.0 m drilled depth.
- LIDC412 intersected 7.65 m (7.5 m true width) @ 3.55 g/t from 19.0 m drill depth.
- 40 drill holes for a combined 2,170 m of infill and RC replacement drilling completed within La India Starter Pits.
Mark Child, Chairman and CEO commented:
“A drill intersect in LIDC406 of 17.90 m (17.4 m true width) at 3.27 g/t gold from 24.55 m drill depth, including 2.1 m @ 15.1 g/t gold is highly encouraging and adds considerable confidence to the geological model, the mineral resource and reserve calculation and mine plan. The drill intercept is within the northern La India Starter pit, which is within the fully permitted main La India open pit mineral reserve. The geology team has done an excellent job and completed 40 drill holes for a combined 2,170 m of infill and RC replacement drilling within the two La India starter pits. Assay results for only 6 drill holes have been received to date. Approximately 1,400 m drilling remains to be completed of the current drill programme”
Latest Assay Results
Results have now been received for the first six drill holes which were all located at the northern end of the Northern Starter Pit. The results of the first two holes, which were reported in an RNS dated the 9th March, only tested the footwall part of the main mineralised structure. The latest results include two drill holes that sampled the entire main mineralised structure. Both of these drill holes returned significant gold intercepts, confirming continuity of gold mineralisation in the La India structure and supporting the geological model used in the mineral resource and reserve estimation:

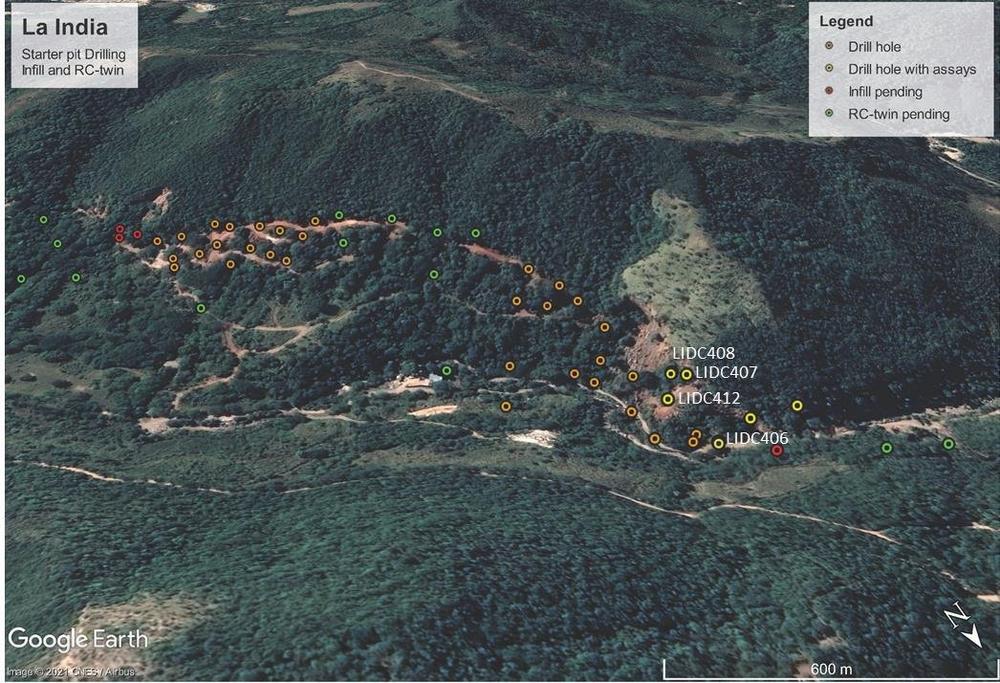

1. Drill hole LIDC406,(Figure 2). tested a zone where the main mineralized structure bifurcates into two close spaced vein stacks, both of which are strongly brecciated along the structure. Shallow level artisanal mining activity was intersected, but it has only stoped a 0.8 m width of the upper structure. Both mineralized structures have returned significant intercepts of
17.90 m (17.4 m true width) at 3.27 g/t gold from 24.55 m drill depth, including both
i. 4.45 m (4.3 m true width) at 4.20 g/t gold from 24.55 m drill depth, and
ii. 9.35 m (9.1 m true width) at 4.20 g/t gold from 33.90 m drill depth, including 2.1 m @ 15.13 g/t
2. Drill hole LIDC412 which was drilled approximately 50 m along strike to the southwest of LIDC406 where the mineralization merges to form one single main mineralized structure. This hole also returned a significant drill intercept of 7.65 m (7.5 m true width) at 3.55 g/t gold from 19.00 m drill depth which is consistant with the geological model (Figure 3).
The remaining two drill holes (LIDC407 and LIDC408) were both collared (started) within the surface expression of the main mineralised zone drilling. The Main Zone mineralisation has been interpreted as being eroded where LIDC407 was started, but an intercept of 4.40 m (4.3 m true width) at 3.20 g/t gold shows that there is gold mineralization in the footwall at grades that warrant further investigation (Figure 3).
Drilling Programme – Looking Ahead
The drilling programme is constantly being assessed and adapted based on geological observations from core logging. Quartz veins and breccias have been identified within the footwall host rock, in some cases, 10 to 20 m below the Main Vein in both the Northern and Southern Starter Pits. Consequently, selected neighbouring infill drill holes are being extended beyond the originally planned depth to target the footwall quartz vein and brecias. The goal is to rapidly upgrade and potentially extend, (on the footwall targets) existing inferred mineral resources to the indicated mineral resource category, and their potential inclusion in the mine schedule.
To-date approximately 2,120 m of diamond core drilling has been completed. It is anticipated that another 265 m of drilling will be required to complete the 25 m-spaced infill and RC-drill replacement drilling within and immediately adjacent to the two Starter Pits.
Following completion of the drilling in the Southern Starter Pit, the next stage in the infill drilling programme is to twin drill an additional 14 RC drill holes (1142 m of drilling) that are located within the La india mineral resource pit shell.
About the Drilling Techniques
Drilling is being undertaken using heavy duty track-mounted drilling rigs. All of the drilling is being undertaken using diamond core drilling techniques employing large diameter PQ core barrels and triple tube in the mineralised zones to ensure good sample recovery. Drilling close to surface and in proximity to historical and artisanal mine workings can present challenges to the driller, however, the drilling programme is benefitting from employment of local geologists, field support staff and experienced drill contractors, all with a decade of experience of drilling at la India. Consequently, all target depths have been met and good sample recovery is being achieved.
About the Assaying
Drill core is cut, and half core samples collected and bagged by Condor staff on-site. Samples are transported to Bureau Veritas accredited sample preparation laboratory in Managua every week in batches of two or three drill holes, generally being submitted to the lab within 5-10 days of completing the drill hole. Sub-samples of the pulverised rock samples are forwarded for assay to Bureau Veritas accredited analytical laboratory in Vancouver, Canada. As with many other operators delays in the return of assay results are being experienced due to industry demand and COVID-19 pandemic restrictions.
About the Starter Pits
On 25 January 2019, SRK Consulting (UK) Limited completed an updated Mineral Resource Estimate (the “MRE”; see RNS dated 28 January 2019) on Condor’s 100% owned La India Project in Nicaragua comprising 9.85 million tonnes (“M tonnes” or “Mt”) at 3.6 g/t gold for 1,140,000 oz gold in the Indicated category and 8.48M tonnes at 4.3g/t gold for 1,179,000 oz gold in the Inferred category.
The La India Vein Set hosts an open pit Mineral Resource of 8,377kt at 3.1g/t gold for 837Koz gold in the Indicated category and 887kt at 2.4 g/t gold for 69,000oz gold in the Inferred category. Beneath the La India open pit is an underground Mineral Resource estimate of 678kt at 4.9g/t gold for 107Koz gold in the Indicated category and 1,718kt at 5.6 g/t gold for 309,000 oz gold in the Inferred category.
The 25 January 2019 MRE update did not materially change the La India open pit Mineral Resource estimate and consequently the 2014 Pre-Feasibility Study (“PFS”) remained unchanged. La India open pit has an existing Probable Mineral Reserve of 6.9 million tonnes (“Mt”) at 3.01 g/t gold for 675,000 oz gold.
As announced on 4 March 2020 (see RNS), Condor completed internal studies on readily accessible high-grade material within the permitted La India open pit. The starter pits within La India open pit contain a diluted tonnage of 387Kt at 4.29g/t gold for 53,000 oz gold. Condor has subsequently further advanced these studies. Within a designed pit shell, the starter pits have two scenarios. At 0.75g/t gold cut-off grade, 635Kt at 3.32g/t gold for 67,800 oz gold with a 4.5 to 1 strip ratio. Using a 2.0g/t cut-off grade, 445Kt at 4.17g/t gold for 59,700 oz gold with a 6.8 to 1 strip ratio. See table 1 below:
For further information please visit www.condorgold.com
